Revision and Self-Assessment on Moving Average Class-11 OP Malhotra Exe-31B ISC Maths Solutions

WhatsApp Group Join Now

Revision and Self Assessment on Moving Average Class 11 OP Malhotra Exe-31B ISC Maths Solutions Ch-31. In this article you would learn to solve all type questions easily on Moving Average. Step by step solutions of latest textbook has been given as latest syllabus. Visit official Website CISCE for detail information about ISC Board Class-11.

Revision and Self-Assessment on Moving Average Class-11 OP Malhotra Exe-31B ISC Maths Solutions

ICSEHELP Premium Slider

Moving Average Class 11 OP Malhotra Revision and Self Assessment ISC Maths Solutions Ch-31

Board ICSE
Publications S Chand
Subject Maths
Class 11th
Chapter-31 Index Numbers
Writer OP Malhotra
Exe-31(B) Revision and Self Assessment.

Revision and Self Assessment on Moving Average

OP Malhotra ISC Class 11 Maths Solutions

Que-1: The following table gives the recorded monthly sales figures of a certain type of television for the 18-month period commencing 1st January 1989.
Year Jan Feb March April May June
1989 18 16 23 27 28 19
1989 31 29 35 27 28 24
1990 24 28 29 30 29 22
Calculate the 6-monthly moving averages and display these and the original figures on the same graph using the same axes for both. Comment briefly on the purpose of moving average graphs.

Sol: First, list the data in sequence:
18, 16, 23, 27, 28, 19, 31, 29, 35, 27, 28, 24, 24, 28, 29, 30, 29, 22
Now calculate 6-month moving averages:
1st average = (18+16+23+27+28+19)/6 = 131/6 ≈ 21.83
2nd average = (16+23+27+28+19+31)/6 = 144/6 = 24
3rd average = (23+27+28+19+31+29)/6 = 157/6 ≈ 26.17
4th average = (27+28+19+31+29+35)/6 = 169/6 ≈ 28.17
5th average = (28+19+31+29+35+27)/6 = 169/6 ≈ 28.17
6th average = (19+31+29+35+27+28)/6 = 169/6 ≈ 28.17
7th average = (31+29+35+27+28+24)/6 = 174/6 = 29
8th average = (29+35+27+28+24+24)/6 = 167/6 ≈ 27.83
9th average = (35+27+28+24+24+28)/6 = 166/6 ≈ 27.67
10th average = (27+28+24+24+28+29)/6 = 160/6 ≈ 26.67
11th average = (28+24+24+28+29+30)/6 = 163/6 ≈ 27.17
12th average = (24+24+28+29+30+29)/6 = 164/6 ≈ 27.33
13th average = (24+28+29+30+29+22)/6 = 162/6 = 27
These values are plotted against time.
Purpose of Moving Average:
Moving averages help to smooth out short-term fluctuations and highlight long-term trends in the data. They make it easier to understand the general direction of sales over time.

Que-2: The following table gives the numbers of failures of commercial industries in a country during the years 1975 to 1990.
Year 1975 1976 1977 1978 1979
No. of failures 23 26 28 32 20
Year 1980 1981 1982 1983 1984
No. of failures 12 12 10 9 13
Year 1985 1986 1987 1988 1989 1990
No. of failures 11 14 12 9 3 1
Draw a graph illustrating the figures. Calculate the 4-yearly moving average and plot them on the same graph.

Sol: First list data:
23, 26, 28, 32, 20, 12, 12, 10, 9, 13, 11, 14, 12, 9, 3, 1
Now calculate 4-year moving averages:
1st avg = (23+26+28+32)/4 = 109/4 = 27.25
2nd avg = (26+28+32+20)/4 = 106/4 = 26.5
3rd avg = (28+32+20+12)/4 = 92/4 = 23
4th avg = (32+20+12+12)/4 = 76/4 = 19
5th avg = (20+12+12+10)/4 = 54/4 = 13.5
6th avg = (12+12+10+9)/4 = 43/4 = 10.75
7th avg = (12+10+9+13)/4 = 44/4 = 11
8th avg = (10+9+13+11)/4 = 43/4 = 10.75
9th avg = (9+13+11+14)/4 = 47/4 = 11.75
10th avg = (13+11+14+12)/4 = 50/4 = 12.5
11th avg = (11+14+12+9)/4 = 46/4 = 11.5
12th avg = (14+12+9+3)/4 = 38/4 = 9.5
13th avg = (12+9+3+1)/4 = 25/4 = 6.25
Plot both original data and moving averages on the graph.
Moving averages smooth fluctuations and clearly show the long-term trend of industrial failures.

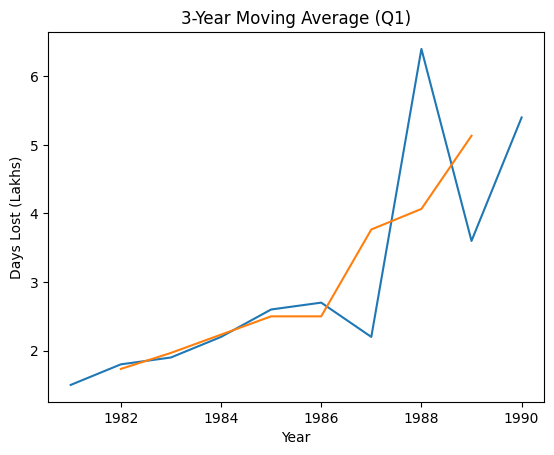

Que-3: The average number, in lakhs, of working days lost in strikes during each year of the period 1981–90 was:
Year 1981 1982 1983 1984 1985 1986 1987 1988 1989 1990
Days lost 1.5 1.8 1.9 2.2 2.6 2.7 2.2 6.4 3.6 5.4
Calculate the 3-yearly moving average and draw the moving average graph.

Sol: Given data:
1.5, 1.8, 1.9, 2.2, 2.6, 2.7, 2.2, 6.4, 3.6, 5.4
Now calculate 3-year moving averages:
1st = (1.5 + 1.8 + 1.9)/3 = 5.2/3 = 1.73
2nd = (1.8 + 1.9 + 2.2)/3 = 5.9/3 = 1.97
3rd = (1.9 + 2.2 + 2.6)/3 = 6.7/3 = 2.23
4th = (2.2 + 2.6 + 2.7)/3 = 7.5/3 = 2.50
5th = (2.6 + 2.7 + 2.2)/3 = 7.5/3 = 2.50
6th = (2.7 + 2.2 + 6.4)/3 = 11.3/3 = 3.77
7th = (2.2 + 6.4 + 3.6)/3 = 12.2/3 = 4.07
8th = (6.4 + 3.6 + 5.4)/3 = 15.4/3 = 5.13
These averages are plotted against middle years to draw the graph.
The average number, in lakhs, of working days lost in strikes during each year of the period 1981–90 was:

WhatsApp Group Join Now

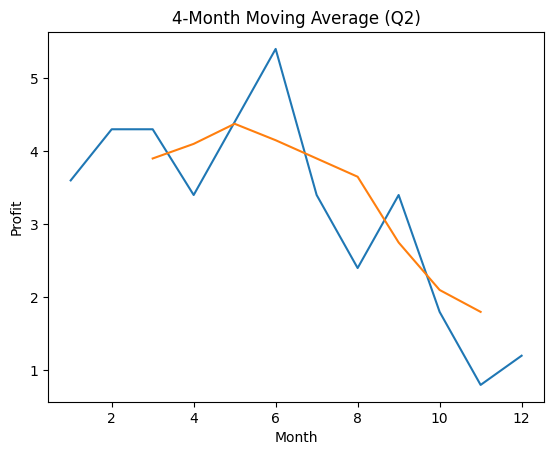

Que-4: The profit of a soft drink firm (in thousands of rupees) during each month of the year is as given below:
Month Jan Feb Mar Apr May June July Aug Sep Oct Nov Dec
Profit 3.6 4.3 4.3 3.4 4.4 5.4 3.4 2.4 3.4 1.8 0.8 1.2
Calculate the 4-monthly moving averages and plot graph.

Sol: First 4-month average:
(3.6 + 4.3 + 4.3 + 3.4)/4 = 15.6/4 = 3.9
Next:
(4.3 + 4.3 + 3.4 + 4.4)/4 = 16.4/4 = 4.1
Similarly:
(4.3 + 3.4 + 4.4 + 5.4)/4 = 17.5/4 = 4.38
(3.4 + 4.4 + 5.4 + 3.4)/4 = 16.6/4 = 4.15
(4.4 + 5.4 + 3.4 + 2.4)/4 = 15.6/4 = 3.9
(5.4 + 3.4 + 2.4 + 3.4)/4 = 14.6/4 = 3.65
(3.4 + 2.4 + 3.4 + 1.8)/4 = 11/4 = 2.75
(2.4 + 3.4 + 1.8 + 0.8)/4 = 8.4/4 = 2.1
(3.4 + 1.8 + 0.8 + 1.2)/4 = 7.2/4 = 1.8
Plot both original and averages on graph.
Que-4: The profit of a soft drink firm (in thousands of rupees) during each month of the year is as given below:

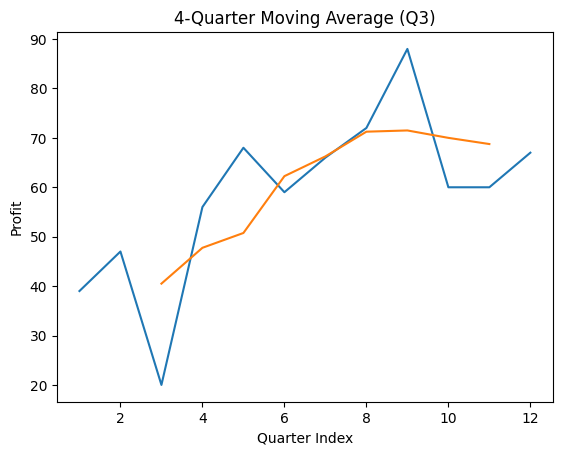

Que-5: The quarterly profits of a small scale industry (in thousands of rupees) is as follows:
Year Q1 Q2 Q3 Q4
2012 39 47 20 56
2013 68 59 66 72
2014 88 60 60 67
Calculate 4-quarterly moving averages.

Sol: Example:
(39+47+20+56)/4 = 162/4 = 40.5
(47+20+56+68)/4 = 191/4 = 47.75
(20+56+68+59)/4 = 203/4 = 50.75
(56+68+59+66)/4 = 249/4 = 62.25
(68+59+66+72)/4 = 265/4 = 66.25
(59+66+72+88)/4 = 285/4 = 71.25
(66+72+88+60)/4 = 286/4 = 71.5
(72+88+60+60)/4 = 280/4 = 70
(88+60+60+67)/4 = 275/4 = 68.75
Plot graph accordingly.
Que-5: The quarterly profits of a small scale industry (in thousands of rupees) is as follows:

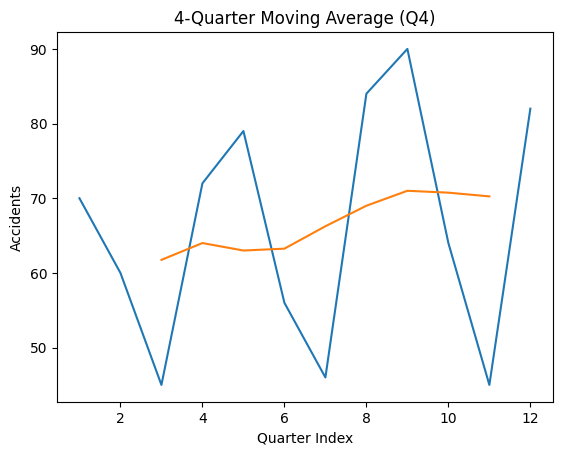

Que-6: The number of road accidents in the city due to rash driving over a period of 3 years is given below:
Year Jan–Mar Apr–June July–Sept Oct–Dec
2010 70 60 45 72
2011 79 56 46 84
2012 90 64 45 82
Calculate four quarterly moving averages and illustrate graph.

Sol: Take 4 consecutive quarters:
(70+60+45+72)/4 = 247/4 = 61.75
(60+45+72+79)/4 = 256/4 = 64
(45+72+79+56)/4 = 252/4 = 63
(72+79+56+46)/4 = 253/4 = 63.25
(79+56+46+84)/4 = 265/4 = 66.25
(56+46+84+90)/4 = 276/4 = 69
(46+84+90+64)/4 = 284/4 = 71
(84+90+64+45)/4 = 283/4 = 70.75
(90+64+45+82)/4 = 281/4 = 70.25
Plot both original data and averages on graph.
Moving averages help to identify long-term trends and remove fluctuations.
Que-6: The number of road accidents in the city due to rash driving over a period of 3 years is given below:

–: End Moving Average Class 11 OP Malhotra Exe-31B ISC Maths Ch-31 Solutions :–
